Watershed

Fix Peachtree Creek – Connected Creek, Connected City

Restoring Atlanta’s Urban Waterway

Atlanta Memorial Park Conservancy (AMPC) is leading an ambitious initiative to restore 7.5 miles of Peachtree Creek, from the confluence of its North and South Forks to the Chattahoochee River.

Peachtree Creek runs through the heart of Atlanta Memorial Park and is a major tributary of the Chattahoochee River. Decades of erosion, sedimentation, stormwater runoff, invasive vegetation and degraded water quality have harmed the creek’s habitat and limited public enjoyment.

Fix Peachtree Creek is AMPC’s signature watershed initiative to reverse this decline and create a healthier urban waterway for future generations.

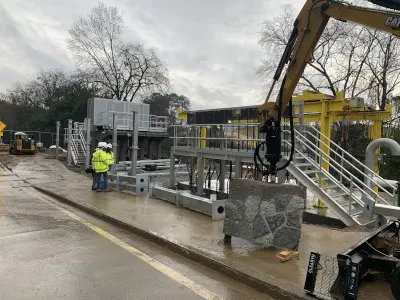

Eroded streambank in Peachtree Creek at Atlanta Memorial Park
Eroded Streambank in Peachtree Creek @ Atlanta Memorial Park

A 7.5-Mile Vision, Backed by Completed Planning

Beginning in 2023, AMPC engaged Davey Resource Group to assess Peachtree Creek and develop conceptual restoration plans. Conceptual planning for the full 7.5-mile corridor is now complete. The studies provide a framework for restoration priorities, project phasing, fundraising and public engagement.

Fix Peachtree Creek 7.5-mile corridor map
Fix Peachtree Creek’s 7.5-mile corridor – Source: AMPC Case for Support stakeholder map

Our first priority is the approximately 1.5-mile stretch within Atlanta Memorial Park. This work is designed to serve as a model for restoring the remaining six miles.

Phase I: Restoration Within Atlanta Memorial Park

Phase 1A extends approximately 2,400 linear feet downstream from the Dellwood Drive pedestrian PATH bridge toward the Tanyard Creek confluence near Northside Drive.

Phase 1B will continue west toward Howell Mill Road. Together, they cover approximately 1.5 miles of Peachtree Creek in the park.

Proposed restoration work includes:

  • Stabilizing eroding streambanks with nature-based techniques and native vegetation
  • Reducing sediment and installing in-stream structures to improve channel stability and aquatic habitat
  • Restoring floodplain wetlands and native streamside plant communities
  • Controlling invasive vegetation and supporting long-term stewardship
  • Improving access for fishing, paddling, environmental education and passive recreation
  • Adding appropriate trail connections, overlooks, a wetland boardwalk and interpretive signage
Peachtree Creek Phase I conceptual restoration plan by Davey Resource Group
Conceptual restoration treatments within Atlanta Memorial Park
Source: Davey Resource Group, 2025. Final design and approvals remain ahead.

Funding and Momentum

In October 2026, AMPC submitted a pre-application to the Georgia Outdoor Stewardship Program (GOSP) requesting $3 million for Phase 1A.

The proposed project budget includes approximately $1.025 million in matching funds.

In October 2026, the City of Atlanta approved a $1 million funding commitment, through legislation sponsored by Council Member Mary Norwood and signed by Mayor Andre Dickens.

The GOSP request is competitive and has not yet been awarded. AMPC is working to secure additional private and public support to move restoration from planning to implementation.

A Coalition for Change

AMPC is collaborating with public agencies, neighborhood groups, environmental organizations and institutions along the creek corridor.

Partners and stakeholders include the City of Atlanta, Georgia Building Authority, Chattahoochee Riverkeeper, Bobby Jones Golf Course Foundation, The Atlanta Opera, and community organizations across the watershed.

In 2026, AMPC completed a fundraising feasibility study with Bedrock Group. The study underscored the importance of a long-term restoration vision, broad community support and sustained stewardship.

Community Update Coming in Early 2027

AMPC plans to host a public update meeting in early 2027 to share the results of the completed 7.5-mile conceptual study, provide the latest Phase I funding and planning news, and discuss next steps.

Meeting details will be announced when available. Community input will continue to inform project design.

Stewardship Is Already Underway

While preparing for major restoration, AMPC and its partners are acting now.

Professional invasive-vegetation management is underway in portions of the creek corridor, coordinated with the Peachtree Battle Alliance and The Atlanta Opera. Bobby Jones Golf Course partners are also addressing invasive species along the south bank.

AMPC continues to work with Trees Atlanta on volunteer forest restoration and Chattahoochee Riverkeeper on creek cleanups.

Environmental education and responsible recreational access will be important parts of the project. AMPC is also drawing on Georgia Tech Research Institute research into water-condition information, interpretive signs and resources for creek users.

Our Watershed History

AMPC was founded in 2011 following the damaging floods of 2009. Watershed protection has been one of the Conservancy’s three core priorities, alongside greenspace and connectivity.

For years, AMPC worked closely with the City of Atlanta Department of Watershed Management (DWM), surrounding neighborhoods and technical experts on sewer overflows, infrastructure and flooding that affected Peachtree Creek and Atlanta Memorial Park.

Following additional flooding and sewer overflows in 2015, AMPC helped establish a Technical Advisory Group in 2016. This collaboration helped advance discussion and coordination of several significant infrastructure improvements:

  • Inspection, cleaning and rehabilitation of approximately 11,000 linear feet of the Peachtree Creek sewer trunk
  • Clearing debris from sewer relief lines within the park
  • Removal of aerial sewer crossings near Howell Mill Road and Woodward Way in 2019–2020
  • Construction of DWM’s North Fork Storage Tank and Pump Station to improve wastewater storage and conveyance capacity
  • Ongoing monitoring, infrastructure maintenance and coordination on environmental issues

In 2025, AMPC’s Executive Director was appointed to the Infrastructure-Sustainability Task Force convened by Council Member Mary Norwood to review important watershed infrastructure challenges.

These efforts helped lay the foundation for AMPC’s next major priority: restoring the ecological health of Peachtree Creek itself.

Help Restore Peachtree Creek

Fix Peachtree Creek represents a long-term investment in a cleaner, healthier, and more accessible waterway for generations to come.

AMPC’s Annual Fund Campaign is currently underway. Contributions to the Annual Fund support the Conservancy’s day-to-day operations and ongoing efforts to restore, enhance, and preserve Atlanta Memorial Park. This annual support is essential to the work we do throughout the year.

A separate fundraising campaign dedicated to Fix Peachtree Creek will launch in 2027. This campaign will focus on securing the funding needed to implement the creek restoration project. Stay tuned for more details and opportunities to support this transformational initiative!

In the meantime, anyone wishing to make a contribution specifically designated for Fix Peachtree Creek may contact AMPC’s Executive Director, Catherine Spillman, at 678-871-0612.
